Tomography tutorial (EMPIAR-10164)

This tutorial shows how to convert raw tilt-series from EMPIAR-10164 into a ~3A resolution structure of immature HIV-1 Gag protein.

We first use the command line to download and decompress a .tbz file containing a subset of 5 tilt-series (down-sampled 2x compared to the original super-resolution data):

# cd to a location in the shared file system and run:

wget https://nextpyp.app/files/data/nextpyp_tomo_tutorial.tbz
tar xvfz nextpyp_tomo_tutorial.tbz

After this, you should have 41 tilt movies in .tif format for each of the tilt-series (TS_01, TS_03, TS_43, TS_45, and TS_54), an initial reference, and a shape mask

Open your browser and navigate to the url of your nextPYP instance (e.g., https://nextpyp.myorganization.org).

Step 1: Create a new project

Data processing runs are organized into projects. We will create a new project for this tutorial
  • The first time you login into nextPYP, you should see an empty Dashboard:

    Create new project

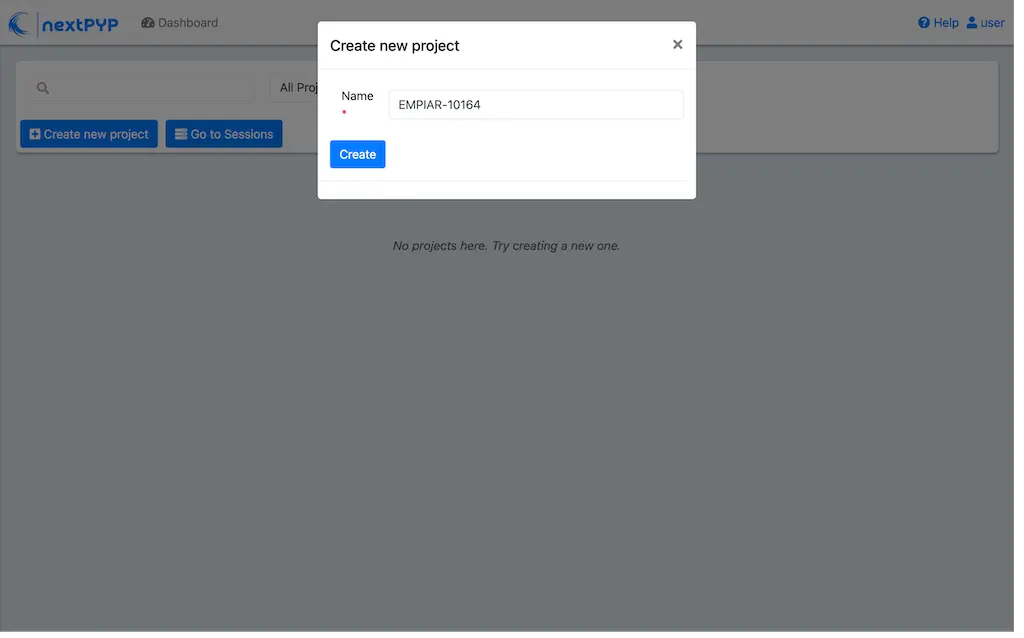

  • Click on Create new project, give the project a name, and select Create

    Create new project
  • Select the new project from the Dashboard and click Open

    Select new project
  • The newly created project will be empty and a Jobs panel will appear on the right

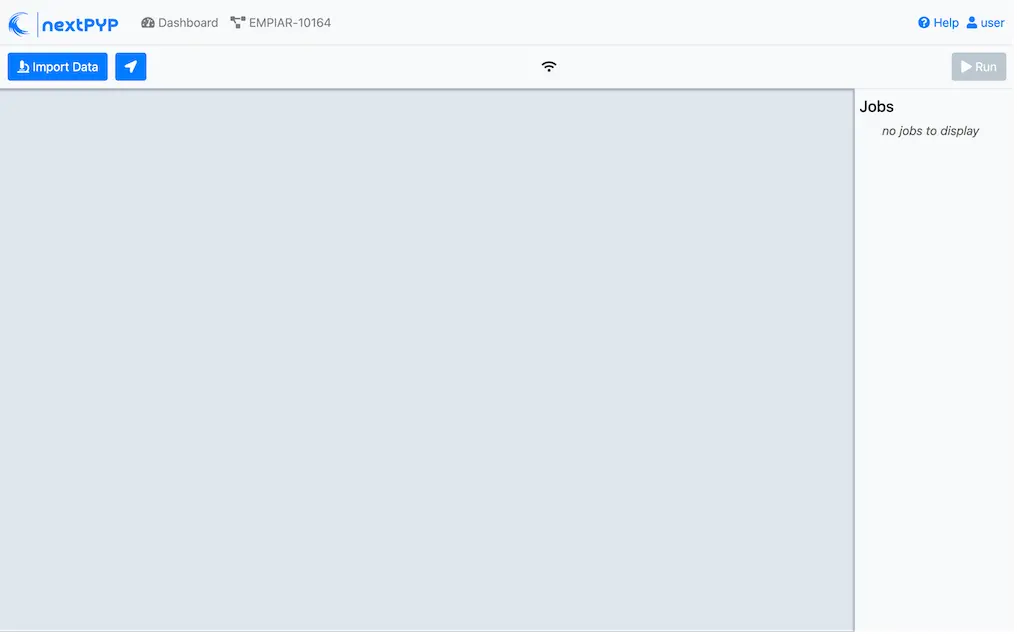

    Empty project

Step 2: Import raw tilt-series

Import the raw tilt-series downloaded above ( <1 min)
  • Go to Import Data and select Tomography (from Raw Data)

    Import dialog
  • A form to enter parameters will appear:

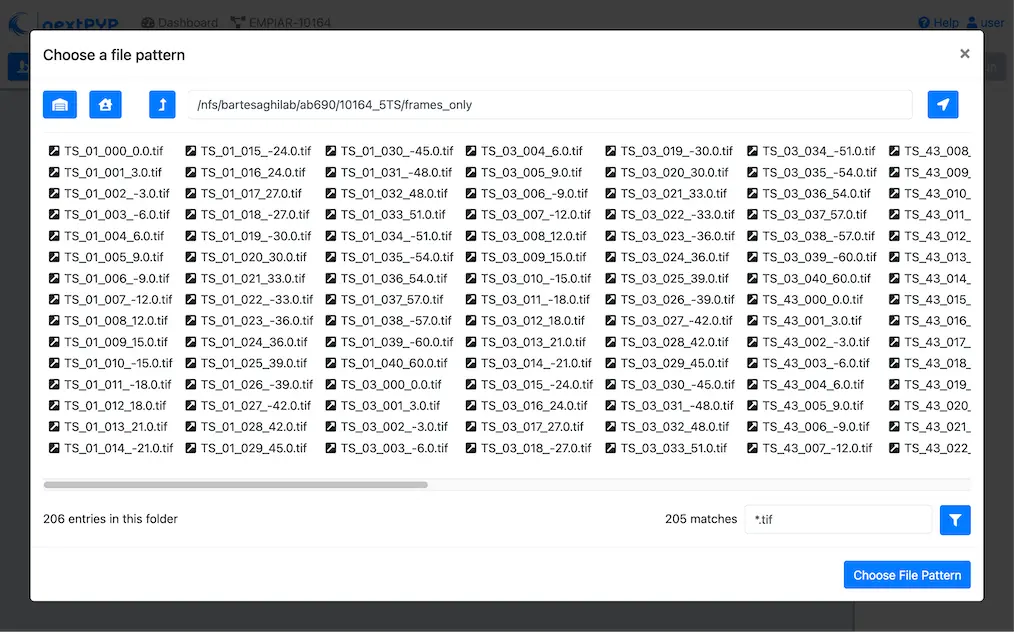

    File browser
  • Go to the Raw data tab:

    • Set the Location of the raw data by clicking on the icon and browsing to the directory where the you downloaded the raw movie frames

    • Type TS_*.tif in the filter box (lower right) and click on the icon to verify your selection. 205 matches should be displayed

    • Click Choose File Pattern to save your selection

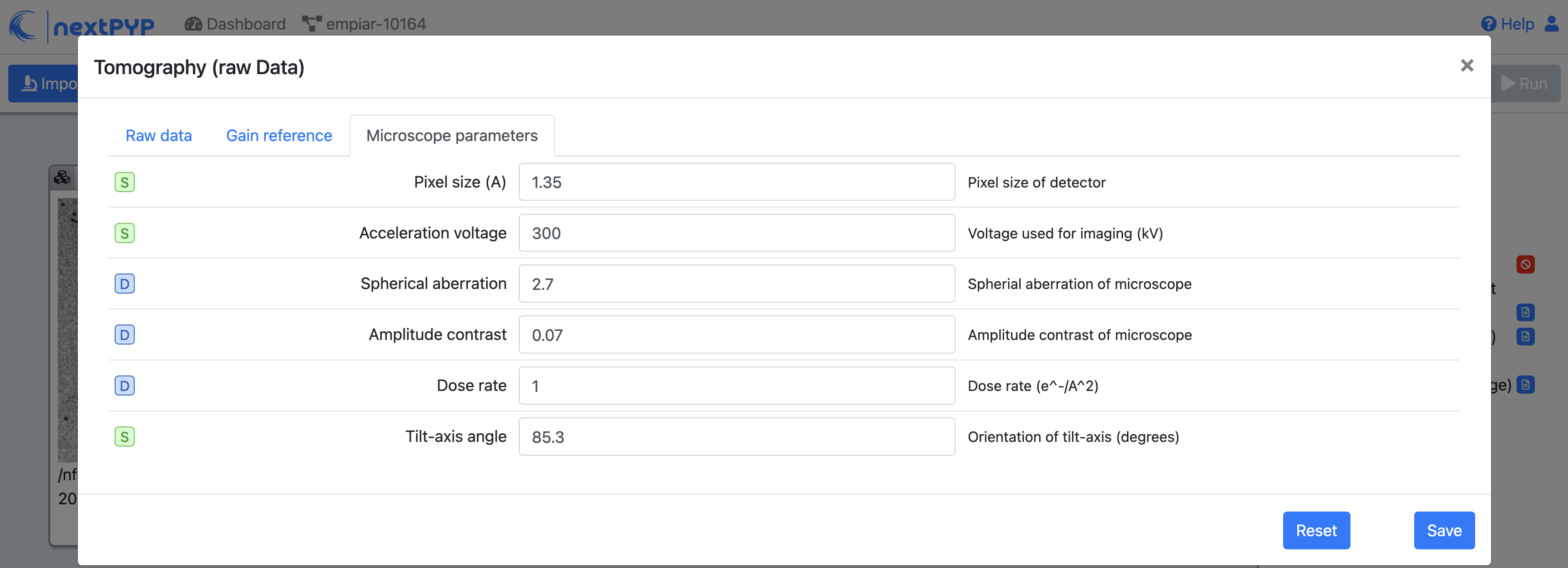

    • Click on the Microscope parameters tab

    File browser
    • Set Pixel size (A) to 1.35

    • Set Acceleration voltage (kV) to 300

    • Set Tilt-axis angle (degrees) to 85.3

    Project dashboard
  • Click Save and the new block will appear on the project page

    Project dashboard
  • The block is in the modified state (indicated by the sign) and is ready to be executed

  • Clicking the button Run will show another dialog where you can select which blocks to run:

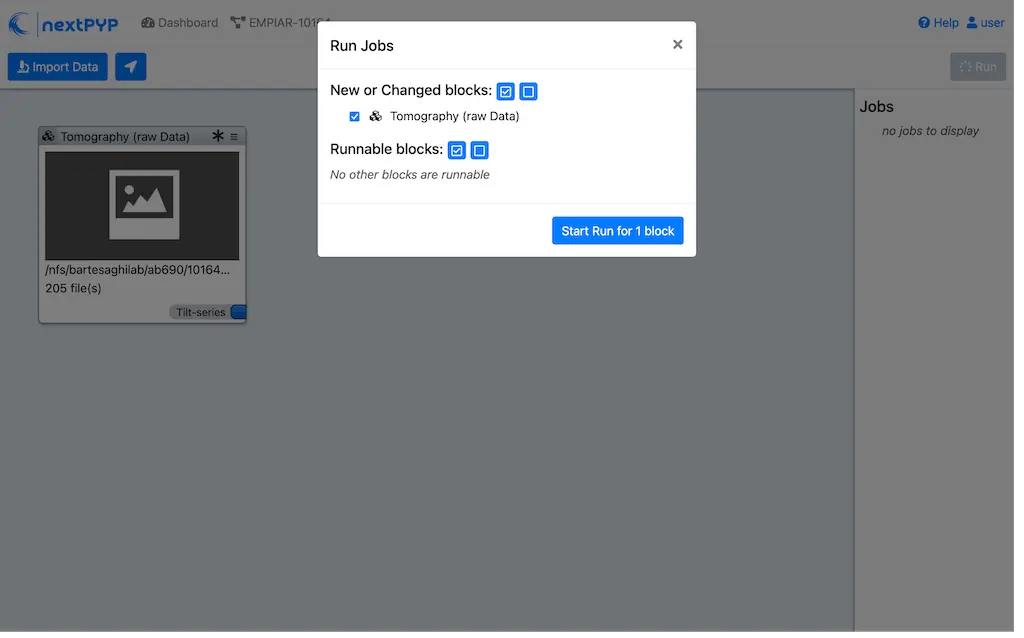

    Gain thumbnail

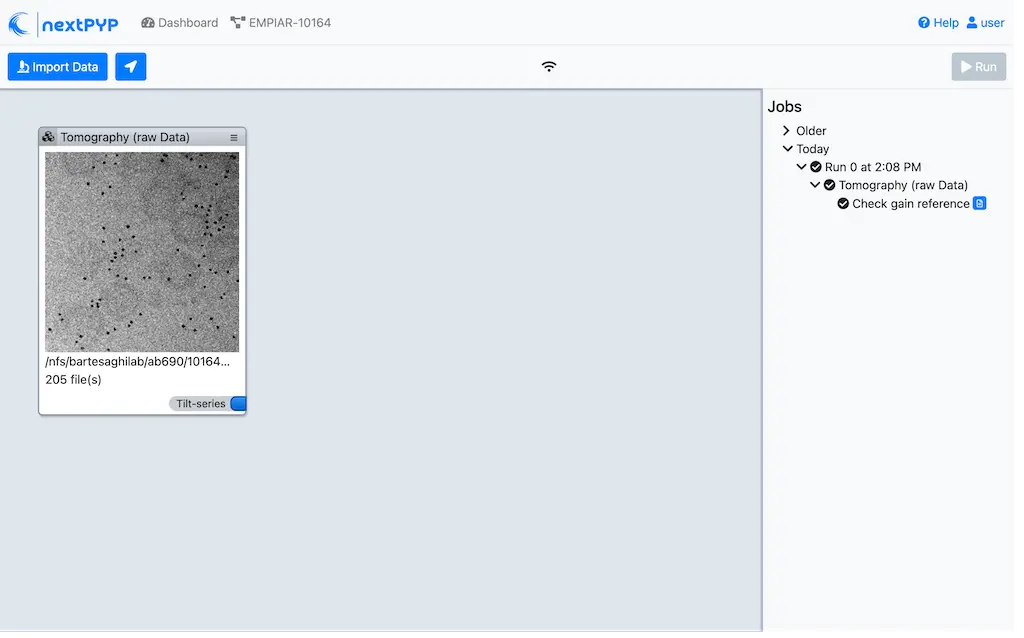

  • Since there is only one block available, simply click on Start Run for 1 block. This will launch a process that reads one tilt at random and displays the resulting image inside the block

    Gain thumbnail
  • Click on the thumbnail inside the block to see a larger version of the projection image

Step 3: Pre-processing

Motion correction, CTF estimation, tilt-series alignment and reconstruction ( 5 min)

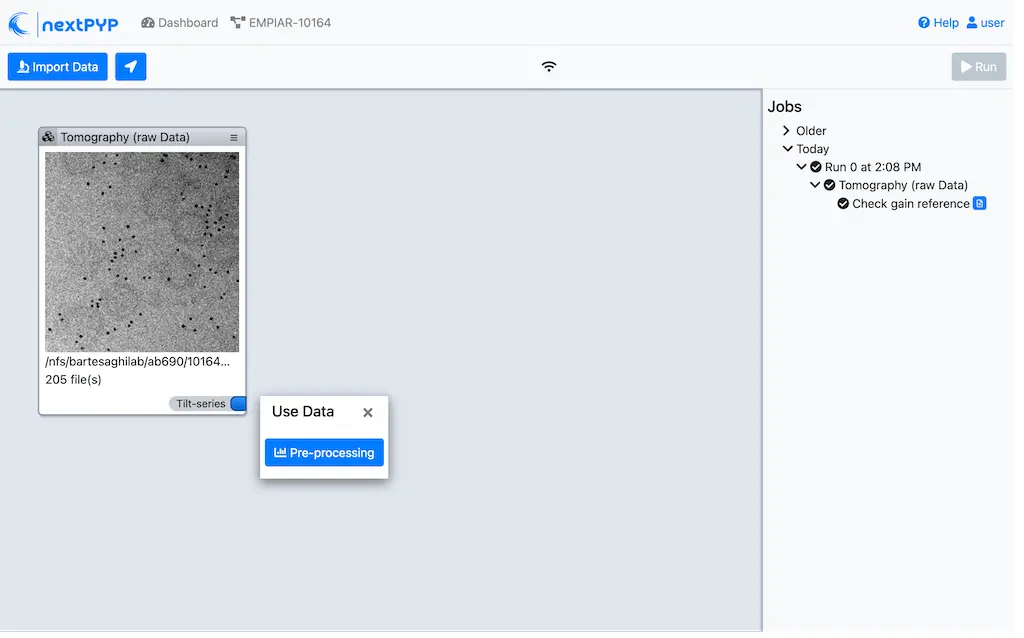

  • Click on Tilt-series (output of the Tomography (from Raw Data) block) and select Pre-processing

    File browser
  • Go to the Frame alignment tab:

    • Leave Frame pattern as the default value TILTSERIES_SCANORD_ANGLE.tif. nextPYP uses this to extract the metadata from the file names, for example, TS_54_037_57.0.tif would indicate that the tilt-series name is TS_54, the exposure acquistion order is 37, and the corresponding tilt-angle is 57.0 degrees

    • Click on the CTF determination tab

    • Set Max resolution (A) to 5. This will be the maximum resolution used to determine the CTF parameters for each tilt-series

    • Click on the Resources tab

    • Set Split, Threads to 11. This tells nextPYP to use 11 threads to process each tilt-series

    • Set other runtime parameters as needed (see Computing resources)

  • Click Save, Run, and Start Run for 1 block. Follow the status of the run in the Jobs panel

    File browser
  • Click inside the Pre-processing block to inspect the results (you don’t need to wait until processing is done to do this). Results will be grouped into tabs:

    Dataset statistics

    Table view

    Gallery view

    Tilt-series (Tilts)

    Tilt-series (Alignment)

    Tilt-series (CTF)

    Tilt-series (Reconstruction)

    Tip

    While on the Tilt Series tab, use the navigation bar at the top of the page to look at the results for other tilt-series

Step 4: Virion selection

Selection of virion centers ( 1 min)
  • Click on Tomograms (output of the Pre-processing block) and select Particle picking

  • Go to the Particle detection tab:

    • Set Detection method to virions

    • Set Virion radius (A) to 500

  • Click Save, Run, and Start Run for 1 block. Follow the status of the run in the Jobs panel

Step 5: Virion segmentation

Segment individual virions in 3D ( 1 min)
  • Click on Particles (output of the Particle picking block) and select Segmentation (min-flow/max-cut)

  • Click Save, Run, and Start Run for 1 block. Follow the status of the run in the Jobs panel

This next step is optional, but it showcases tools available in nextPYP to work with virions:

  • Go inside the Segmentation (min-flow/max-cut) block and click on the Segmentation tab

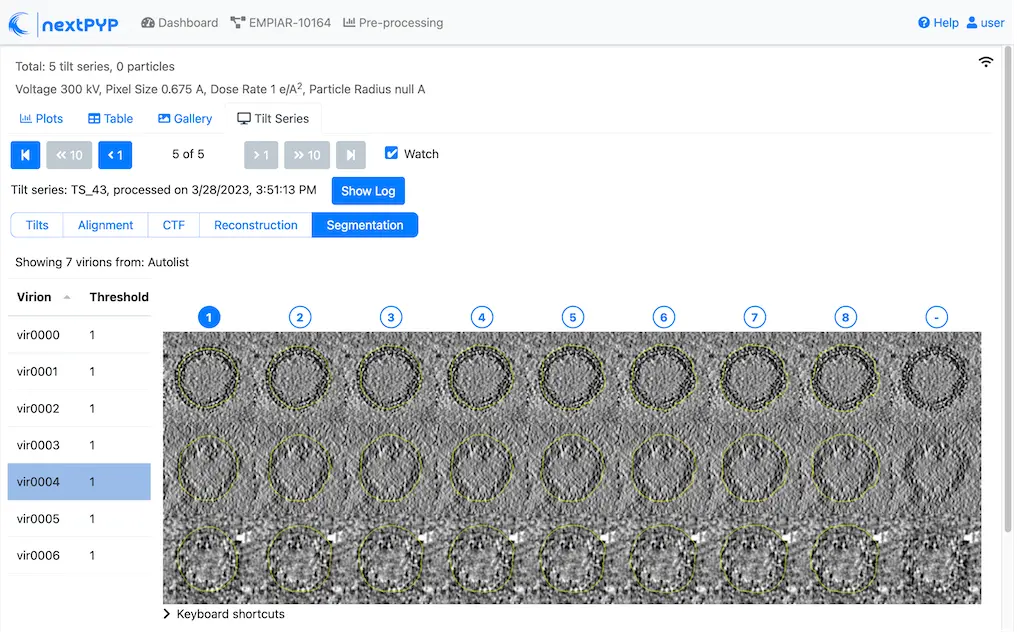

    Virion segmentation
  • Select a virion from the table to show its 3D segmentation (8 different thresholds are shown as yellow contours in columns 1-8). The column number highlighted in blue represents the selected threshold value (default is 1, click on a different column to select a better threshold). The best threshold is the one that more closely follows the outermost membrane layer. If none of the columns look reasonable (or if you want to ignore the current virion), select the last column (“-“)

  • Repeat this process for all virions in the table and all tilt-series in the dataset

    Tip

    Click on > Keyboard shortcuts (under the virion image) to reveal instructions on how to speed up the threshold selection process

Step 6: Particle picking

Select particles from the surface of virions ( 3 min)
  • Click on Segmentation (min-cut/max-flow) (output of the Segmentation (min-flow/max-cut) block) and select Particle picking (closed surfaces)

  • Go to the Particle detection tab:

    • Set Particle radius (A) to 50

    • Set Detection method to uniform. This will select uniformaly distributed particles on the virion surfaces

    • Set Minimum distance between particles (voxels) to 8

    • Set Size of equatorial band to restrict search (A) to 800. Given that the virions are 1000 A in diameter, this setting limits the search to 80% of the surface area, avoiding particle selection from the top and bottom regions of the virions where the missing wedge effects are more pronounced

  • Click Save, Run, and Start Run for 1 block. Follow the status of the run in the Jobs panel

  • Navigate to the Particles tab to inspect the particle coordinates:

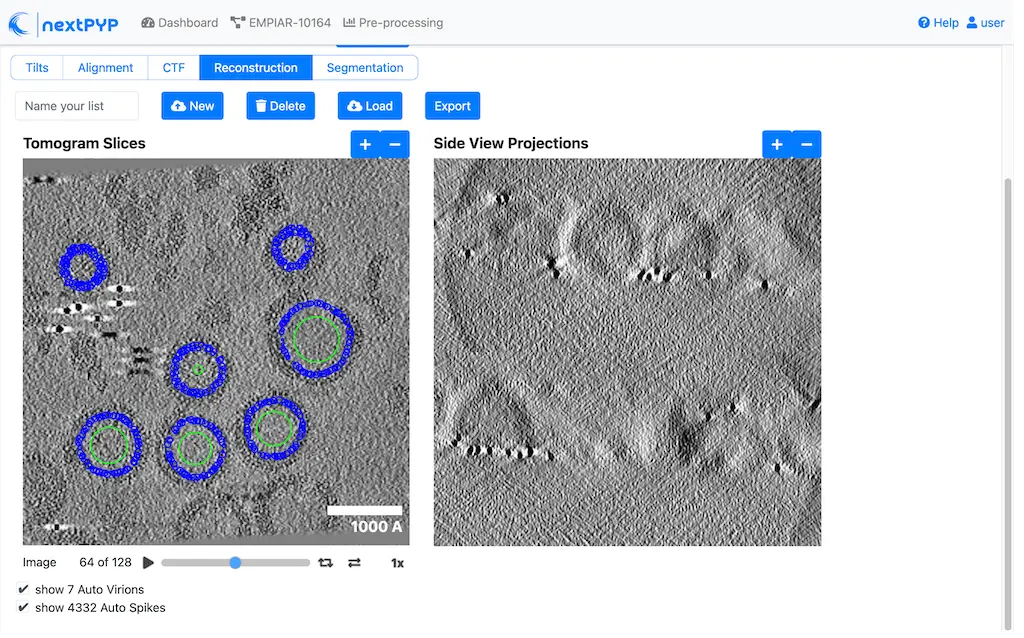

    Spike coordinates

Step 7: Reference-based refinement

Constrained reference-based particle alignment ( 8 hr)
  • Click on Particles (output of the Particle picking (closed surfaces) block) and select Reference-based refinement

  • Go to the Sample tab:

    • Set Molecular weight (kDa) to 300. This value is used by cisTEM to estimate the volume occupied by the particle, based on a conversion factor of 810 Da/nm^3. The estimated volume is used to calculate the spectral signal-to-noise ratio (SSNR), which in turn is used to apply an optimal filter to enhance the reconstruction

    • Set Particle radius (A) to 150

    • Set Symmetry to C6

    • Click on the Particle extraction tab

    • Set Box size (pixels) to 192

    • Set Image binning to 2. Particles will be extracted at 2x binning, as only low-resolution information is needed at this stage

    • Click on the Particle scoring function tab

    • Set Last tilt for refinement to 10. This will use the first eleven tilts for refinement (numbering is 0-based)

    • Set Max resolution (A) to 8.0

    • Click on the Reference-based refinement tab

    • Specify the location of the Initial model (*.mrc) by clicking on the icon , navigating to the folder where you downloaded the data for the tutorial, and selecting the file EMPIAR-10164_init_ref.mrc

    • Set Particle rotation Psi range (degrees) and Particle rotation Theta range (degrees) to 10. This setting restricts the out-of-plane rotation of particles during refinement to a maximum of 10 degrees

    • Set Particle rotation step (degrees) to 2

    • Set Particle translation range (A) to 50

    • Set Particle translation step (A) to 6

    • Click on the Reconstruction tab

    • Check Show advanced options

    • Set Max tilt-angle to 50

    • Set Min tilt-angle to -50

    • Click on the Resources tab

    • Set Split, Threads to the maximum allowable by your system. Since this dataset has thousands of particles per tilt-series, this will allow for a faster processing time.

    • Set Merge, Threads to 6. This will use 6 threads to merge the intermediate results from each tilt-series. Since this is not a CPU-intensive task, using higher values may not be beneficial

  • Save your changes, click Run and Start Run for 1 block

  • One round of refinement and reconstruction will be executed. Click inside the block to see the results

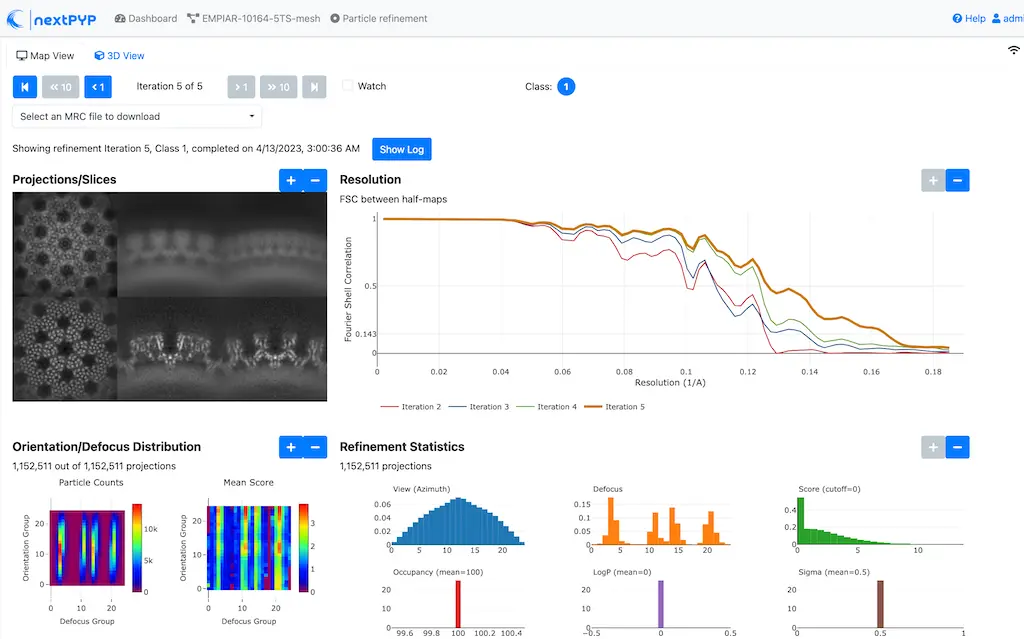

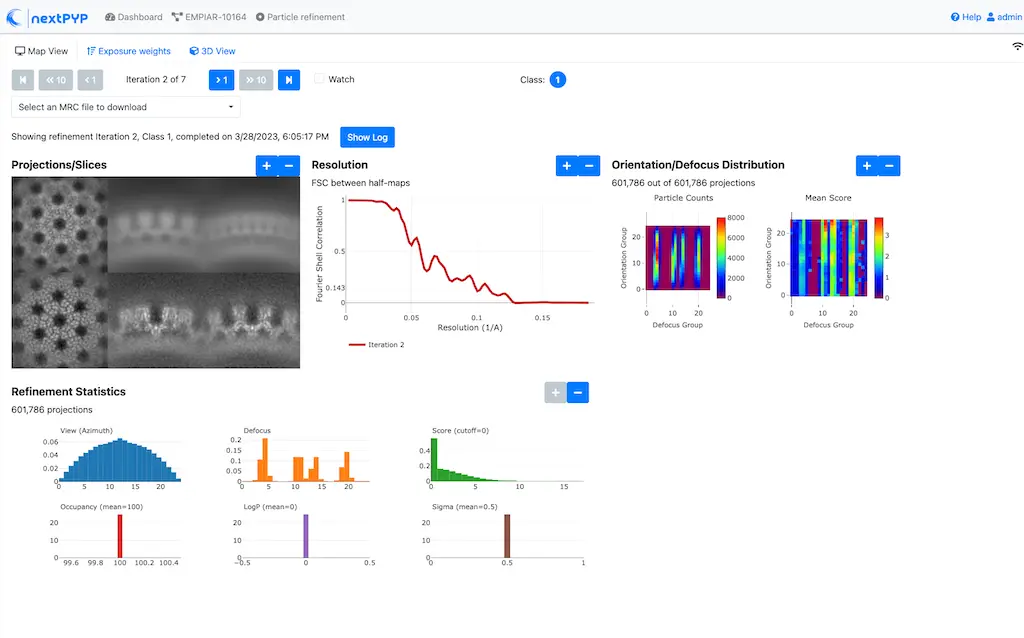

    Iter 2

Step 8. 3D refinement

Tilt-geometry parameters and particle poses refinement ( 1.5 hr)
  • Click on Particles (output of the Reference-based refinement block) and select 3D refinement

  • Go to the Particle scoring function tab:

    • Set Max resolution (A) to 8:7:6. This will use information up to 8 A during the first refinement iteration, up to 7 A during the second, etc.

    • Click on the Refinement tab

    • Specify the location of Input parameter file (*.bz2) by clicking on the icon and selecting the file tomo-reference-refinement-*_r01_02.bz2

    • Set Last iteration to 4

    • Check Refine tilt-geometry to enable refinement of the tilt-axis angle and tilt-angle of each tilt-series projection

    • Check Refine particle alignments to enable refinement of each particle’s 3D rotation and translation

    • Set Particle rotation Phi range (degrees), Particle rotation Psi range (degrees) and Particle rotation Theta range (degrees) to 20.0

    • Set Particle translation range (A) to 100

    • Check Show advanced options

    • Set Optimizer - Max step length to 100

    • Click on the Reconstruction tab

    • Check Apply dose weighting

  • Click Save, Run, and Start Run for 1 block to execute three rounds of refinement and reconstruction

  • Click inside the 3D refinement block to inspect the results:

    Iter 5

    Tip

    Use the navigation bar at the top left of the page to look at the results for different iterations

Step 9. Filter particles

Identify and remove duplicates and particles with low alignment scores ( 4 min)
  • Click on Particles (output of the 3D refinement block) and select Particle filtering

  • Go to the Particle filtering tab:

    • Specify the location of Input parameter file (*.bz2) by clicking on the icon and selecting the file tomo-new-coarse-refinement-*_r01_04.bz2

    • Set Score threshold to 2.5. This will remove particles with scores lower than 2.5 (scores measure the fit between particles and the 3D reconstruction)

    • Set Min distance between particles (unbinned pixels/voxels) to 10. This will remove duplicate particles that are closer than 10 pixels to each other

    • Set Lowest tilt-angle (degrees) to -15. This will exclude projections below -15 degrees, as they contribute little high-resolution information to the reconstruction

    • Set Highest tilt-angle (degrees) to 15. This will exclude projections above 15 degrees, as they contribute little high-resolution information to the reconstruction

    • Check Generate reconstruction after filtering. This will calculate a new reconstruction after filtering the particles to confirm that the filtering was successful

    • Check Permanently remove particles. This will remove the particles from the dataset after filtering to save space and reduce processing time

  • Click Save, Run, and Start Run for 1 block. You can see how many particles were left after filtering by looking at the job logs.

Step 10. Region-based local refinement (before masking)

Constraints of the tilt-geometry are applied over local regions ( 1 hr)
  • Click on Particles (output of Particle filtering block) and select 3D refinement

  • Go to the Sample tab:

    • Set Particle radius to 100

    • Click on the Particle extraction tab

    • Set Box size (pixels) to 384

    • Set Image binning to 1

    • Click on the Particle scoring function tab

    • Set Last tilt for refinement to 4. This will use the first five tilts for refinement (numbering is 0-based)

    • Set Max resolution (A) to 6:5

    • Click on the Refinement tab

    • Select the location of the Initial parameter file (*.bz2) by clicking on the icon and selecting the file tomo-fine-refinement-*_r02_clean.bz2

    • Set Last iteration to 3

    • Set Number of regions to 8,8,2. This will divide the tomogram into 8x8x2 regions in x,y,z and refine the tilt-geometry parameters independently for each region

  • Click Save, Run, and Start Run for 1 block to run the job

  • Click inside the 3D refinement block to inspect the results:

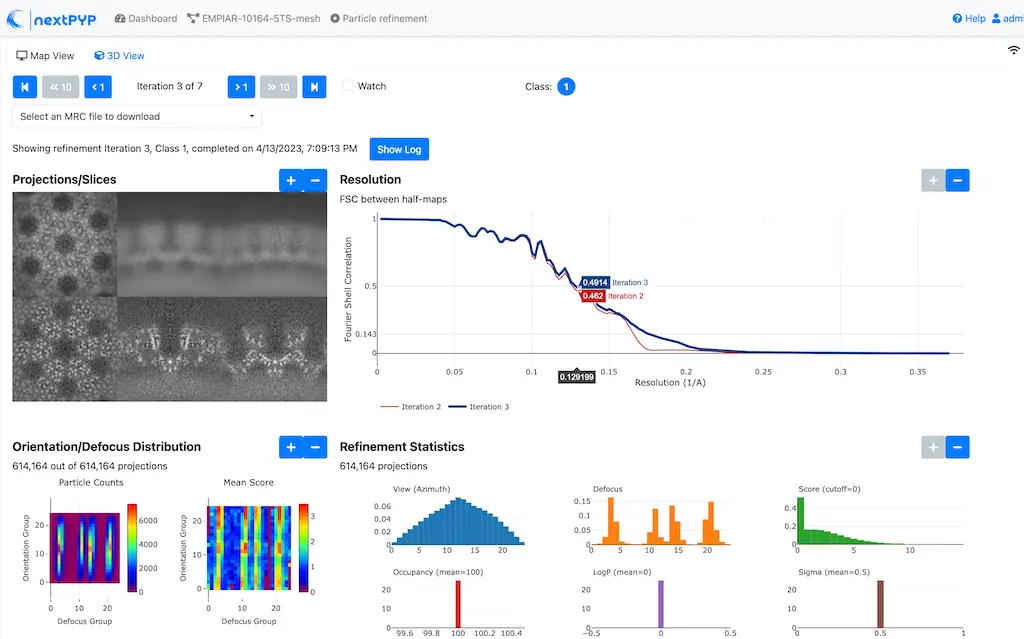

    Iter 3

Step 11: Create shape mask

Use most recent reconstruction to create a shape mask ( <1 min)
  • Click on Particles (output of the last 3D refinement block) and select Masking

  • Go to the Masking tab:

    • Select the Input map (*.mrc) by click on the icon and selecting the file tomo-new-coarse-refinement-*_r01_03.mrc

    • Set Threshold for binarization to 0.45. This value may be different for you. Use the 3D viewer to visualize the map and adjust the threshold value accordingly

    • Set Width of cosine edge (pixels) to 8. This will create a cosine edge of 8 pixels at the edges of the mask to avoid sharp transitions

  • Click Save, Run, and Start Run for 1 block to run the job

  • Click on the menu icon of the Masking block, select the Show Filesystem Location option, and Copy the location of the block in the filesystem (we will use this in the next step))

  • Click inside the Masking block to inspect the results of masking.

Note

A suitable binarization threshold should include the protein density while excluding the background. You may skip this step and use the pre-calculated mask provided with the raw data

Step 12: Region-based constrained refinement

Constraints of the tilt-geometry are applied over local regions ( 2 hr)
  • Click on Particles (output of the last 3D refinement block) and select 3D refinement

  • Go to the Particle scoring function tab:

    • Set Max resolution (A) to 5:4:3.5

    • Set Masking strategy to from file

    • Specify the location of the Shape mask produced in Step 11 by clicking on the icon , navigating to the location of the Masking block by copying the path we saved above, and selecting the file frealign/maps/mask.mrc (you may also use the pre-calculated mask provided with the raw data if you skipped the previous step)

    • Click on the Refinement tab

    • Select the Input parameter file (*.bz2) by click on the icon and selecting the file tomo-new-coarse-refinement-*_r01_03.bz2

    • Set Last iteration to 4

  • Click Save, Run, and Start Run for 1 block to run the job

  • Click inside the 3D refinement block to inspect the results:

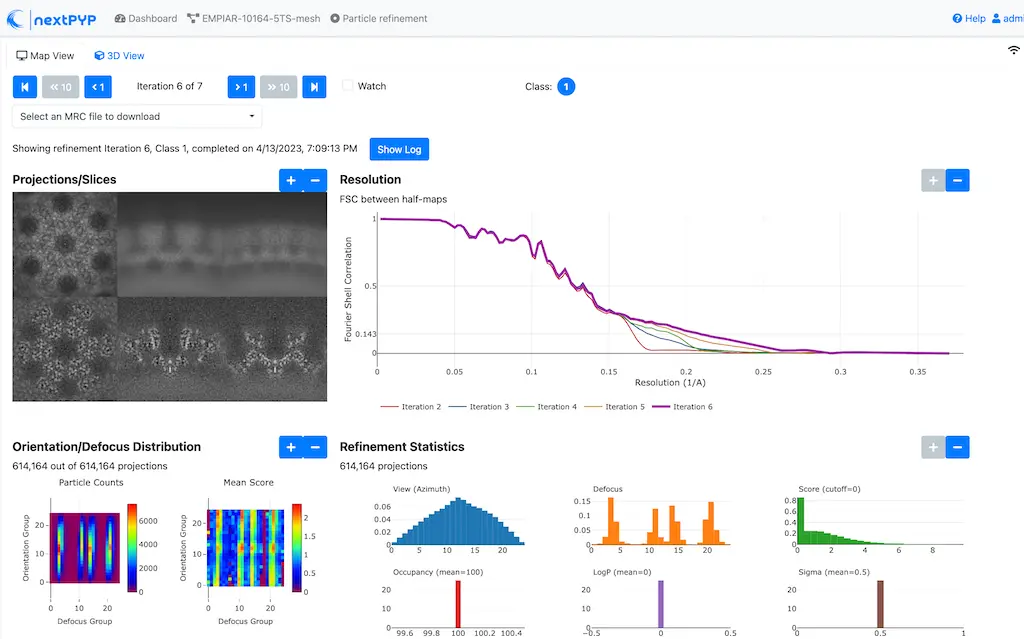

    Iter 6

Step 13: Particle-based CTF refinement

Per-particle CTF refinement using most recent reconstruction ( 3 hr)
  • Click on Particles (output of the last 3D refinement block) and select 3D refinement

  • Go to the Particle scoring function tab:

    • Set Last tilt for refinement to 10

    • Set Max resolution (A) to 3.1

    • Click on the Refinement tab

    • Select the Input parameter file (*.bz2) by click on the icon and selecting the file tomo-new-coarse-refinement-*_r01_02.bz2

    • Uncheck Refine tilt-geometry to disable refinement of the tilt-geometry parameters

    • Uncheck Refine particle alignments to disable refinement of particle poses

    • Check Refine CTF per-particle to enable per-particle CTF refinement. While it’s possible to refine CTF parameters, tilt geometry, and particle poses simultaneously, this is not recommended, as it may increase the risk of overfitting.

  • Click Save, Run, and Start Run for 1 block

  • Click inside the 3D refinement block to inspect the results

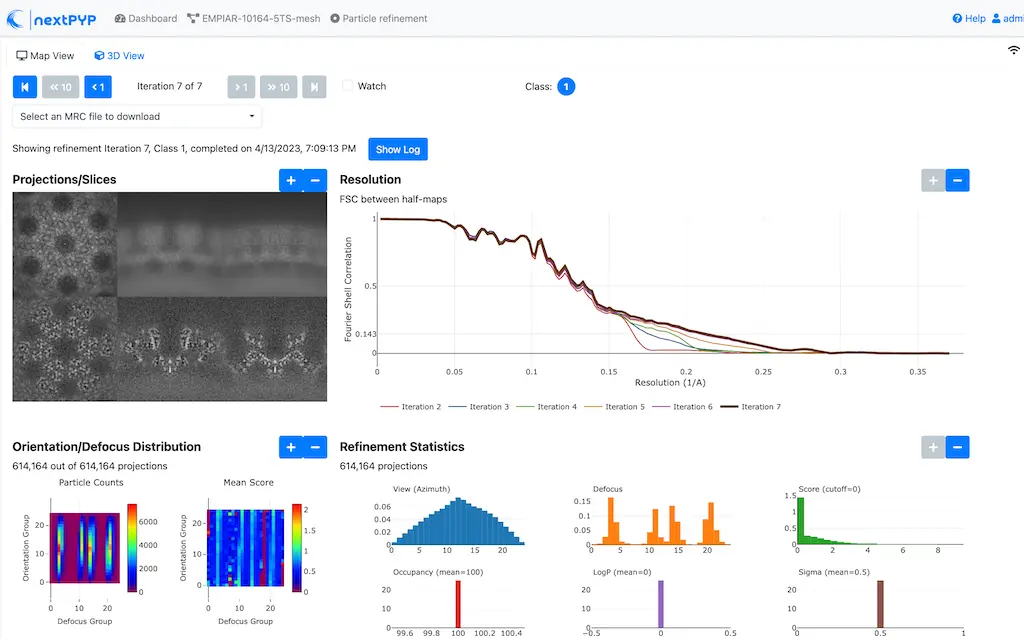

    Iter 7

Step 14: Movie frame refinement

Particle-based movie-frame alignment and data-driven exposure weighting ( 3 hr)
  • Click Particles (output of the last 3D refinement block) and select Movie refinement

  • Go to the Particle scoring function tab:

    • Set Last tilt for refinement to 4

    • Set Max resolution (A) to 3.2

    • Click on the Frame refinement tab

    • Specify the Input parameter file (*.bz2) by clicking on the icon and selecting the file tomo-new-coarse-refinement-*_r01_02.bz2

    • Set Spatial sigma (unbinned pixels/voxels) to 200.0. This ensures that the motion trajectories of neighboring particles within a 200-pixel radius are correlated

  • Click Save, Run, and Start Run for 1 block

  • Click inside the Movie refinement block to inspect the results:

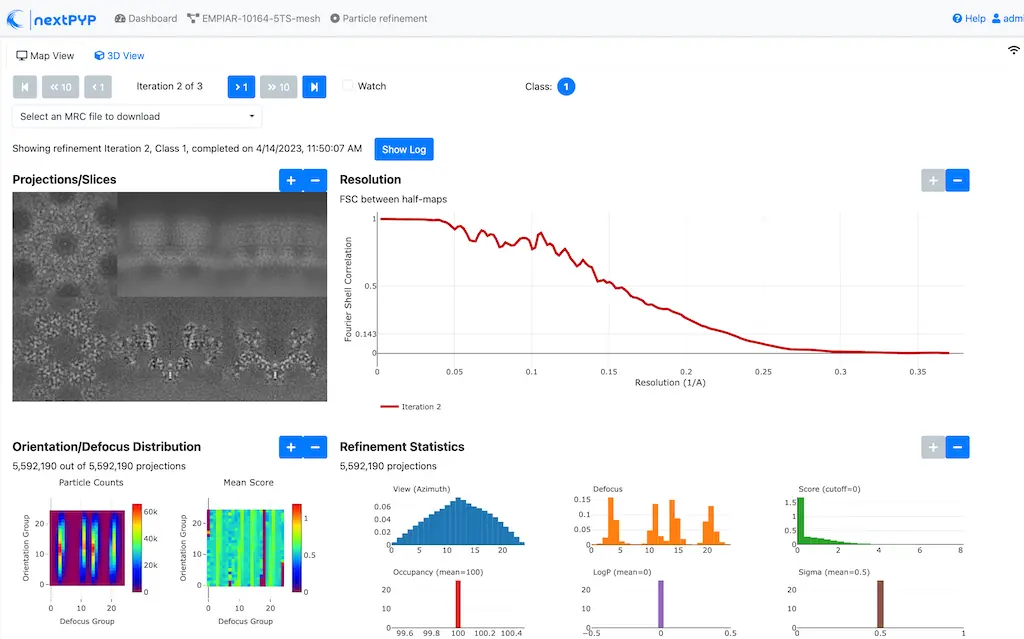

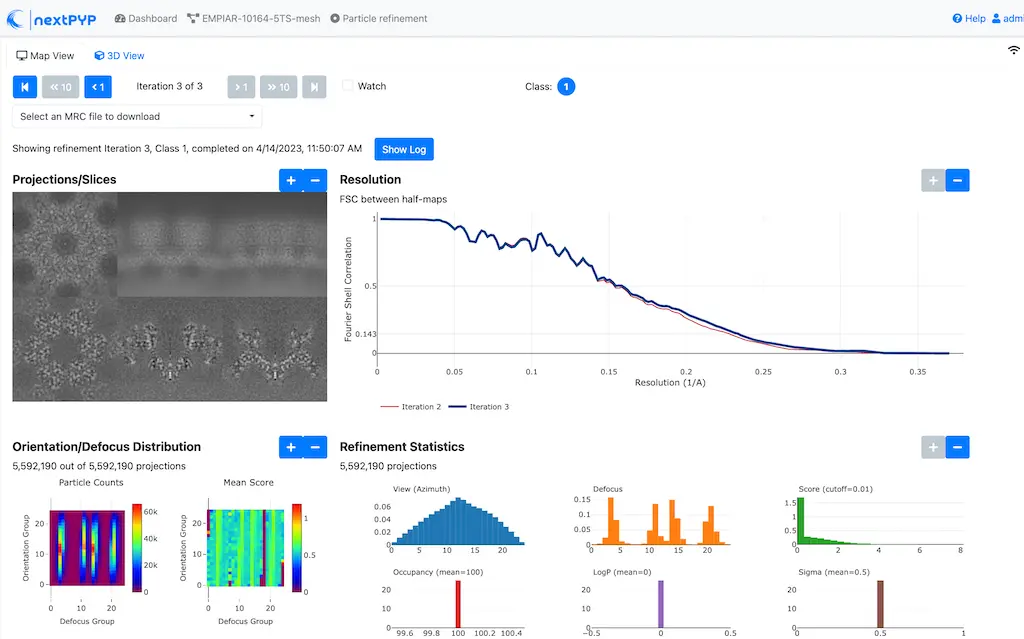

    Iter 2

Step 15: Refinement after movie frame refinement

Additional refinement using new frame alignment parameters ( 1 hr)
  • Click Frames (output of Movie refinement block) and select 3D refinement (after movies)

  • Go to the Particle scoring function tab:

    • Set Min number of tilts for refinement to 2

    • Set Max resolution (A) to 3.2

    • Click on the Refinement tab

    • Specify the Input parameter file (*.bz2) by clicking on the icon and selecting the file tomo-flexible-refinement-*_r01_02.bz2

    • Check Refine tilt-geometry

    • Set Tilt-angle range (degrees) and Tilt-axis angle range (degrees) to 1.0

    • Set Tilt-axis position range (A) to 10.0

    • Check Refine particle alignments

    • Set Particle rotation Phi range (degrees), Particle rotation Psi range (degrees), and Particle rotation Theta range (degrees) to 1.0

    • Set Particle translation range (A) to 10.0

  • Click Save, Run, and Start Run for 1 block

  • Click inside the 3D refinement (after movies) block to inspect the results:

    Iter 3

Step 16: Map sharpening

Apply B-factor weighting in frequency space ( <1 min)
  • Click Frames (output of 3D refinement (after movies) block) and select Post-processing

  • Go to the Post-processing tab:

    • Specify the First half map by clicking on the icon and selecting the file tomo-flexible-refinement-*_r01_half1.mrc (output of the 3D refinement (after movies) block)

    • Set Threshold value to 0.35. This value will be used to calculate the shape mask for the map. The threshold value should be adjusted to include the protein density while excluding the background

    • Set B-factor method to adhoc. This will allow us to set the B-factor value manually

    • Set Adhoc value (A^2) to -25. This value may vary for you—more negative values will apply stronger sharpening. Use the 3D viewer to visualize the map and adjust the B-factor value as needed

  • Click Save, Run, and Start Run for 1 block

  • You can inspect the result by clicking inside the Post-processing block:

    Final map

Info

Running times were measured running all tilt-series in parallel on nodes with 124 vCPUs, 720GB RAM, and 3TB of local SSDs
